Your panels will outlast your roof. Plan for that before you install them.
How detach and reset works, what it costs, and why the order you do things in decides the bill.
The sequencing problem
Two service lives that do not line up, and a bill that arrives years later.
A solar array is designed for twenty-five to thirty years. An asphalt shingle roof in Central Texas — sun, heat cycling, and hail — realistically gives you fifteen to twenty-five. Those two numbers do not line up, and the gap between them is where the expense lives. Most homeowners discover this the way everyone discovers roofing problems: a leak appears under an array that still has fifteen good years on it.
The most useful sentence on this page is this one: if your roof is within about five years of the end of its service life, replace it before you install solar, not after. Doing it in that order costs you a roof you were going to buy anyway. Doing it in the other order costs you the roof plus a detach and reset, and it puts your array in storage for a week.
So before you sign a solar contract, have the roof inspected and get a remaining service-life estimate in writing, with the age of the roof, the condition of the deck, and any existing damage noted. That number, not the solar quote, should decide the sequence. We will give you that assessment through a free inspection, and if the answer is that your roof is fine for another decade, that is what we will write down.
It is worth saying plainly that solar companies are generally not roofing contractors. They are competent at arrays and mostly not in the business of evaluating a roof's remaining life, and the question rarely comes up during a solar sale. That is not usually bad faith — it is simply outside their scope. It is squarely inside ours. If a replacement is close, the cheapest version of this whole project is the one where the roof goes on first.
What detach and reset actually involves
Six stages, two trades, and one detail that determines whether the roof leaks: the mount penetrations.
- 1. System shutdown and electrical disconnect
A qualified electrician or the solar contractor shuts the system down and disconnects it at the inverter and the array. This happens before any roofing crew is on the roof, and it is not roofing scope.
- 2. Panel removal and labeled staging

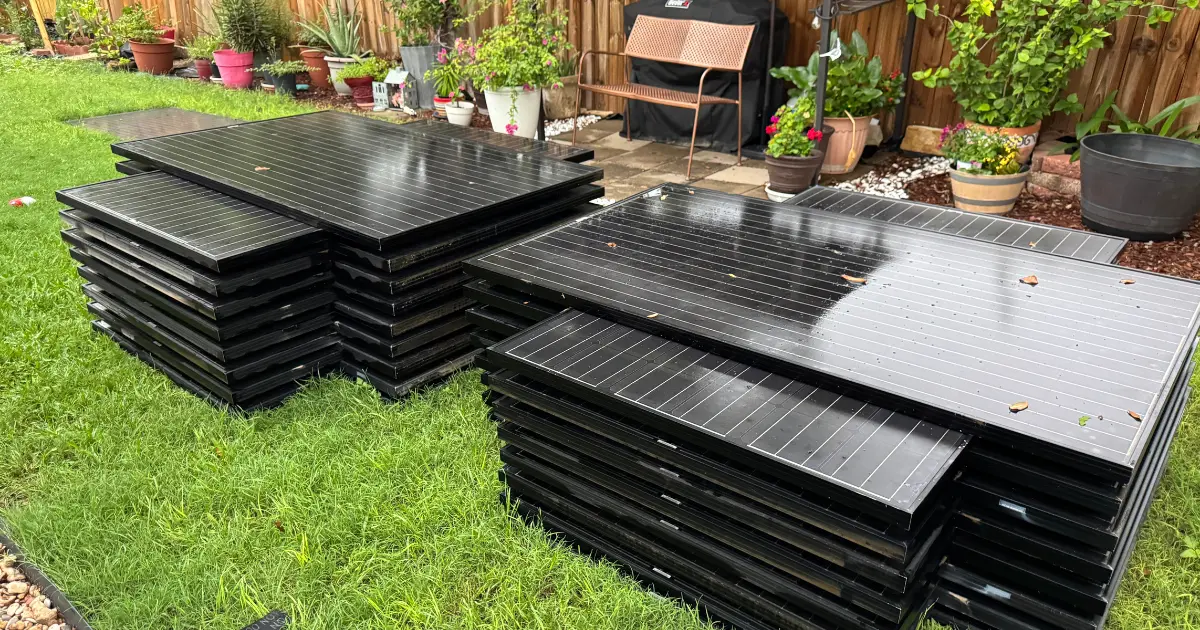

Panels come off in order and are labeled by position and string so the array goes back exactly as designed. They are staged on site where there is safe space for it, or transported and stored when there is not — which is a real cost line, not an afterthought.
- 3. Racking and mounting hardware removal
Rails, clamps, and roof-penetrating feet come off. Rails and clamps are frequently reusable. The feet and their flashings are not, because they were sealed into a roof that is about to be removed.
- 4. Roof replacement, with new flashing at every mount penetration
Tear-off, deck inspection, underlayment, and the new roof system go in as normal — with the difference that every location where a mount will land is treated as a penetration detail rather than a field shingle.
- 5. Racking reinstalled on new, properly flashed mounts
New feet, new flashings, integrated into the new shingle courses so water runs over the detail. Old penetrations are not reused and old sealant is not relied on. This step is the whole point of the exercise.
- 6. Panel reinstall, reconnection, and commissioning

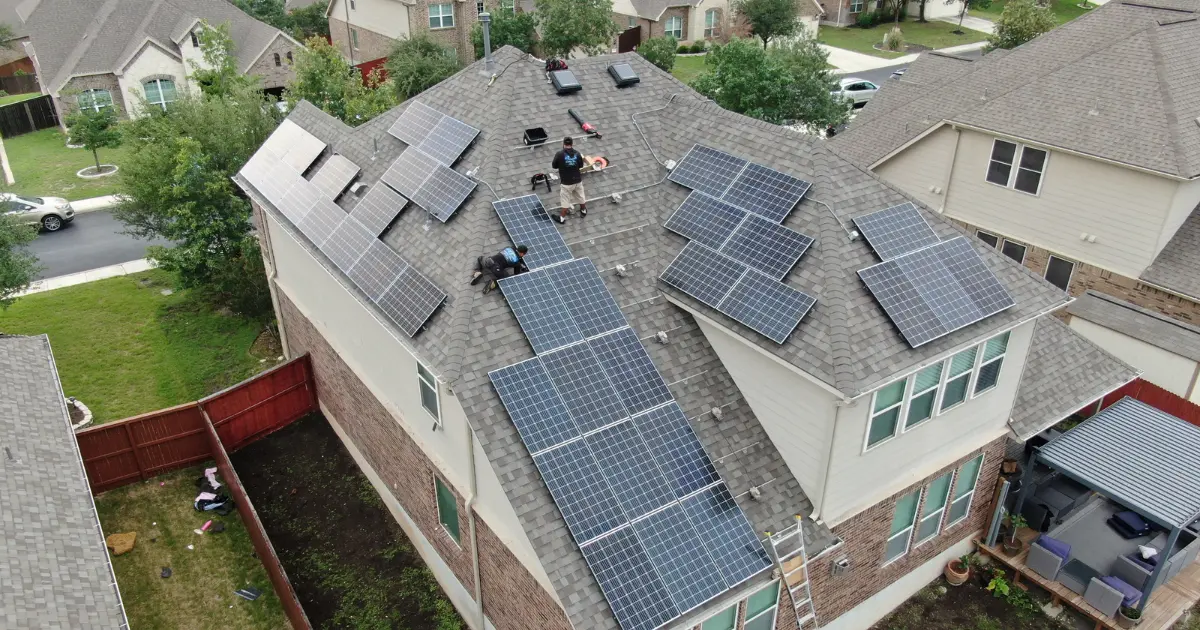

Panels return to their labeled positions, the electrician or solar contractor reconnects and commissions the system, and production is verified against expectation before the job is called finished.
The penetrations are the whole point. Every rack foot is a hole through the water plane, and a residential array typically has dozens of them. Reusing old flashing on a new roof, or setting a new mount into an old hole with sealant, is the same mistake as reusing a skylight flashing kit — it holds for a few seasons and then it does not. New mounts, new flashings, woven into the new shingle courses. There is no shortcut that is still a roof.


Who does what
Clear scope boundaries, honestly stated — including the parts that are not ours.
Roofing contractors handle the roof: tear-off, deck, underlayment, the new system, and the flashing at every penetration the array creates. That is the part of this project that decides whether your house stays dry, and it is the part we do.
Licensed electricians or your solar provider handle the electrical: shutdown, disconnection at the inverter and array, reconnection, commissioning, and production verification. We do not do that work, and we would be suspicious of a roofing company that claimed it did. If a contractor tells you their roofing crew will handle the electrical side themselves, ask who is licensed, ask to see it, and ask what happens to your solar warranty if something goes wrong.
Which brings up the warranty question. If your system is still under warranty, the original installer or their authorized service partner should usually be the one detaching and resetting it, because unauthorized handling can void coverage on panels, inverters, or workmanship. That is not a detail to discover afterward.
What we do is coordinate the sequence — scheduling the shutdown, the tear-off, the reinstall, and the reconnection so nobody is standing on a torn-off roof waiting for someone else to show up. We would rather tell you exactly which parts we own than imply we do all of it.
What it costs
Priced per panel, and it adds meaningfully to a roof replacement.
Detach and reset is almost always quoted per panel rather than as a lump sum, commonly in the range of roughly 150 to 400 dollars per panel. A typical residential array of twenty to thirty panels therefore adds several thousand dollars to a roof replacement, and a large array can add considerably more.
Four things move that number. Panel count is the obvious one. Roof pitch and access matter because a steep or hard-to-reach slope slows every stage. Staging matters — if there is safe space on site to set panels down, cost stays lower; if they have to be transported and stored, that is transport, storage, and additional handling. And the condition of the racking matters, since reusable rails cost less than a full hardware replacement, though the roof-penetrating feet and flashings are replaced regardless.
The thing worth repeating: this is a cost that is avoided entirely by replacing the roof before the panels go up. If you are reading this before a solar install, that is the decision in front of you. If you are reading it after, detach and reset is the correct fix and it is worth doing properly — see roof costs for how the underlying roof project is priced.
Solar and roofing FAQs
Related reading
A written remaining service-life estimate, and an honest answer about whether the roof should come first.
